Biopharma owners are under pressure to bring new facilities online quickly. Rising clinical demand and strict GMP requirements create a construction environment where speed, certainty and quality are critical. To accelerate biopharma facility construction without sacrificing long-term performance, the most successful life sciences capital programs shift critical decision-making earlier in the project timeline. Team alignment and innovative construction strategies remove risk before work reaches the field for fast, compliant delivery of modern biopharma facilities.
Key Strategies to Accelerate Biopharma Facility Delivery
Early Alignment with the Project Partners
Early design and construction team collaboration aligns design verification requirements and constructability with system boundaries and startup sequences to ensure a smooth transition between mechanical completion, commissioning and qualification (C&Q). Collaborative delivery models like design‑build and design-assist identify and resolve critical biopharma construction factors—such as utility routing, equipment placement, material flow and spatial constraints—for greater predictability and reduced rework.
Equally essential is the early involvement of C&Q partners and key trade partners, like process piping specialists, cleanroom installers and mechanical and electrical contractors. With expertise in biopharma-specific systems, they help to identify long‑lead equipment, clarify interface points and sequence installation. This early engagement is critical to properly plan the project with the end in mind.
Design Flexibility for Evolving Pipelines
Biopharma facilities have to be able to adapt to evolving therapies and diverse modalities without requiring major reconstruction. Flexible design strategies allow laboratories and manufacturing environments to evolve alongside changing processes and technologies. Modular cleanrooms, “podular” manufacturing units and adaptable lab layouts can be reconfigured as needs shift to support scale-out manufacturing and help facilities remain productive over time.
Digital Coordination & VDC Integration

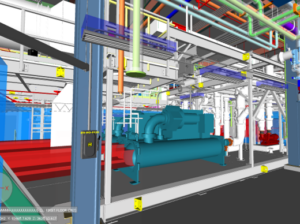

Digital coordination through Virtual Design & Construction (VDC) helps teams resolve clashes and simulate routing before fabrication begins. This is essential for dense biopharma utility systems where precision is critical. Digital modeling reduces field conflicts to support a smoother transition into CQV.
Prefabrication for Fast, Predictable Installation
By shifting work into controlled off‑site factories, prefabrication ensures a safe work environment and results in quality, streamlined production while significantly shortening field installation. Common prefabricated components for biopharma construction include:

Prefabricated HVAC and Plumbing System Coordination
- Multi-trade racks
- Modular process and HVAC skids
- Wall/ceiling utility panels
- Lab gas manifolds
- Electrical rooms
- Cleanroom modules
- Insulated metal panel assemblies
Lean Planning & Pull-Driven Scheduling
Lean construction methods help align all stakeholders around a shared execution plan. Pull planning specifically helps sequence work backward from commissioning, qualification and validation (CQV) milestones to ensure construction activities directly support CQV goals. This reduces variability and keeps all parties focused on project readiness.
Bringing a biopharma facility online faster requires aligning the right partners early, planning with intention and using digital and prefabricated solutions to reduce risk before it reaches the field. When teams make critical decisions upfront and keep CQV outcomes in focus throughout execution, schedules become more predictable and quality improves. The result is a compliant, high-performing facility that supports market demand and can adapt as the market changes.
Where We’ve Done It

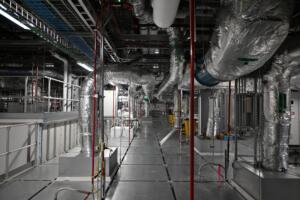

Installation of Prefabricated Systems
At two recent large-scale biopharma manufacturing programs recently delivered for confidential pharmaceutical clients, Consigli constructed over 200,000 sq. ft. of highly regulated, utility-intensive facilities. On one of the projects, Consigli coordinated and installed:
- 70 prefabricated piperacks
- Two HVAC modular skids
- Three process equipment modular skids.
